OPEXSTUDIO
← All lessons and training aids OPEX learning notes / Leadership and daily management

Daily board: measure, respond, learn

Compare actual with standard. Follow the visual, practise a decision, then check your thinking.

Fictional teaching examples and AI-generated illustrations. Proposed changes and goals are not achieved results. Use the written instructions and check local conditions before applying a method.

Download this exact reviewed edition ↗

Teaching view 1 of 2

Daily board: measure, respond, learn

Connected method map: Plan / standard, Actual / gap, Response, Escalated support, Closure evidence. Every authored connection is shown with a numbered arrow and named legend.
Original OPEX teaching diagram. Follow the steps below, then try the practice question. View full size ↗

A daily board should make an important gap visible and connect it to a response. Compare actual performance with a meaningful standard, identify the issue requiring action, and record an owner and review time. Escalate barriers that the team cannot remove, then bring the answer back. Verify whether the condition changed rather than closing an item because an email was sent. Preserve urgent response routes outside the meeting. Repeated gaps may need a deeper investigation. A board full of green indicators is not proof of stability if people have learned to hide exceptions or change the counting rules.

Follow the method

  1. Plan / standard
  2. Actual / gap
  3. Response
  4. Escalated support
  5. Closure evidence

Read the example carefully

All-green reporting can hide problems.

Owner assignment is not closure.

A3 for recurring systemic gaps; Hoshin receives frontline learning.

Teaching view 2 of 2

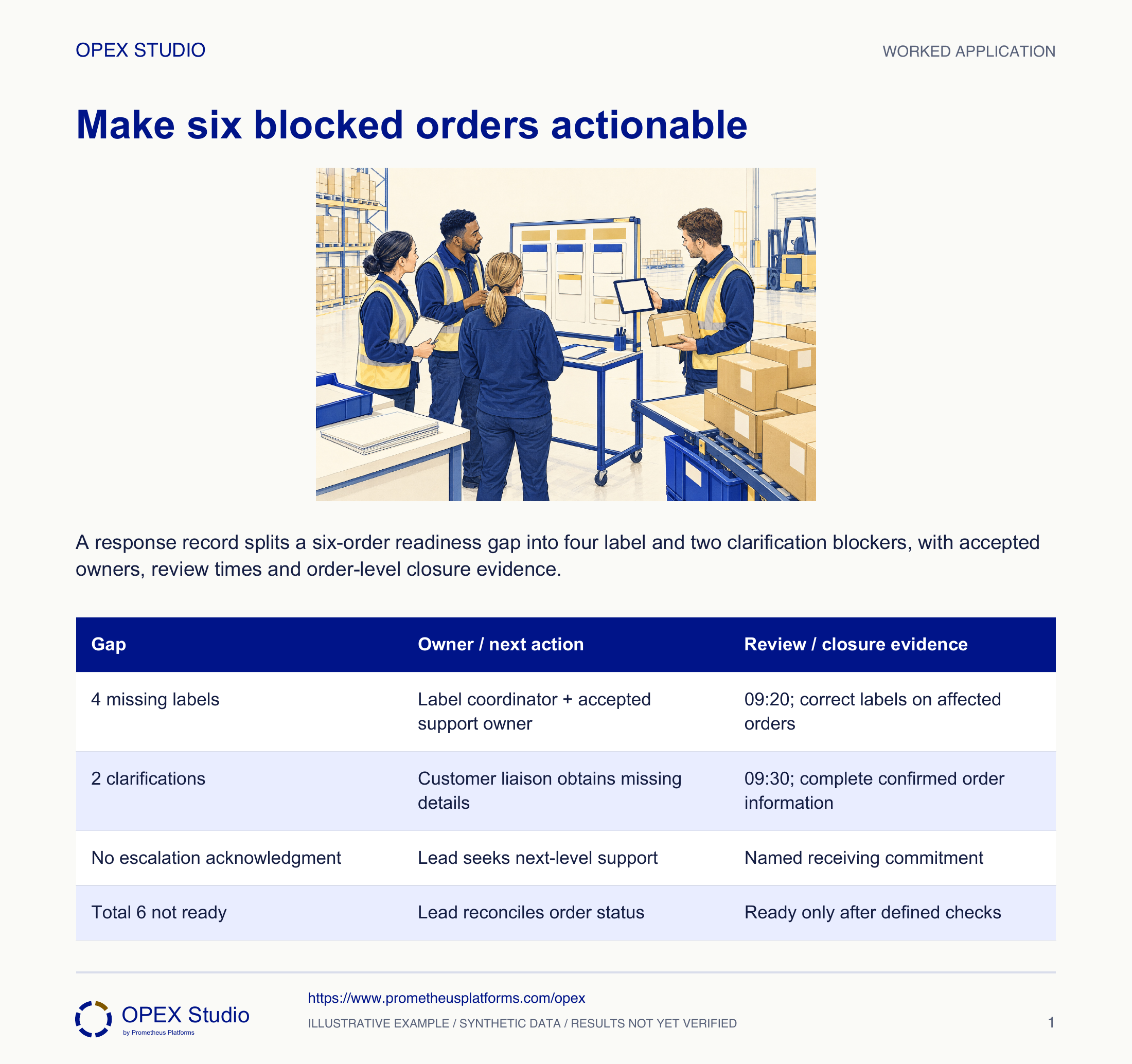

Make six blocked orders actionable

A response record splits a six-order readiness gap into four label and two clarification blockers, with accepted owners, review times and order-level closure evidence.
Original OPEX teaching diagram. Follow the steps below, then try the practice question. View full size ↗

Fictional dispatch huddle: the team planned 24 ready orders by 09:00 and has 18. Four orders await missing labels and two await customer clarification. Yesterday’s board marked a label issue escalated but the support response never returned.

Follow the method

  1. 4 missing labels
  2. 2 clarifications
  3. No escalation acknowledgment
  4. Total 6 not ready

Read the example carefully

Update actual ready to 21 and retain three unresolved orders: one label plus two clarifications. Reopen or continue the specific label response.

A broad fixed message must not turn all four orders green.

Apply the method

The message was sent; the blocker remains

Turn a plan-versus-actual gap into an owned response, use escalation when authority is missing and close only when the receiving team sees evidence.

Fictional dispatch huddle: the team planned 24 ready orders by 09:00 and has 18. Four orders await missing labels and two await customer clarification. Yesterday’s board marked a label issue escalated but the support response never returned.

Role: Dispatch lead and named support owners for label service and customer clarification.

Normal condition

The board shows expected result, actual condition, priority gap, next owner and review evidence.

The gap

Six orders are not ready; a sent escalation is being treated as closure.

  • Ready means all defined checks complete, not merely packed.
  • Do not spend the whole huddle solving every cause; assign focused work and a return point.
Supplied case inputs
09:00 statusCount / evidence
Plan24 ready orders
Actual ready18
Missing labels4 orders; identities retained
Customer clarification2 orders; identities retained
Yesterday’s escalationMessage sent; no acceptance or resolution evidence
  1. Make the gap specific

    The lead records 24 planned minus 18 ready equals 6, then separates four label-blocked orders from two clarification cases.

    Why: A red total alone does not show what support is needed. The categories reconcile the gap without hiding different owners.

    Evidence: Every blocked order has one current primary blocker and an identity.

  2. Assign the next action, not just a name

    The label coordinator checks service status and requests support acceptance; the customer liaison seeks the missing information for the other two orders. Each action has a review time.

    Why: An owner label without the next evidence leaves the board as reporting rather than control.

    Evidence: Label support reviews at 09:20; clarification at 09:30 in this fictional routine.

  3. Escalate the authority gap

    Because label restoration lies outside the dispatch team, the lead seeks an acknowledged support commitment and raises nonresponse through the next level.

    Why: Escalation moves a need to the authority that can act; forwarding an email does not show that authority accepted it.

    Evidence: Receiving owner, expected response and review point appear on the board.

  4. Verify at the work and return to the board

    After support reports recovery, the team checks the affected label outputs and readiness requirements before changing order status. It records any unresolved cases and learning for the next huddle.

    Why: The support task and the customer/work outcome are different closure tests.

    Evidence: Order-level readiness evidence returns to the board; next-day review checks recurrence.

Completed huddle response plan — outcomes pending
GapOwner / next actionReview / closure evidence
4 missing labelsLabel coordinator + accepted support owner09:20; correct labels on affected orders
2 clarificationsCustomer liaison obtains missing details09:30; complete confirmed order information
No escalation acknowledgmentLead seeks next-level supportNamed receiving commitment
Total 6 not readyLead reconciles order statusReady only after defined checks

Support says fixed but one order still fails

A fictional 09:20 review finds three label-blocked orders ready but one label remains incorrect. The two clarification cases are still open.

Update actual ready to 21 and retain three unresolved orders: one label plus two clarifications. Reopen or continue the specific label response.

A broad fixed message must not turn all four orders green.

18 + 3 = 21; 24 minus 21 = 3. Order identities and the failed label evidence remain visible.

A partly successful response

New fictional team planned 15 complete referrals and has 11. Three await a receiving acknowledgment; one has incomplete information. At review, two acknowledgments arrive and are verified; the third and the incomplete case remain unresolved.

Changed practice inputs
StateCount
Plan / initial actual15 / 11
Acknowledgment blockers3
Incomplete information1
Verified newly ready2

Your task

  1. Reconcile initial and revised gaps.
  2. Write separate remaining actions with receiving owners and evidence.
  3. Explain why sent reminders are not closure.

Prepare your worksheet

  • Plan / actual / gap
  • Blocked identities and category
  • Owner / accepted support
  • Review time
  • Verified change / remaining gap
Reveal the answer and reasoning

Initial gap is four. Two verified changes raise complete referrals to 13, leaving two: one acknowledgment and one information gap.

The receiving team must confirm the remaining acknowledgment; the information owner must supply and verify required details. Reminders are actions, not proof of completion.

Review actual records and carry unresolved items honestly into the next cycle.

Worked answer record
Measure / itemResult / next evidence
Revised actual11 + 2 = 13
Remaining gap15 - 13 = 2
AcknowledgmentOne remains; receiver confirmation
InformationOne remains; verified missing detail

Check these interpretations

  • Escalated is not resolved.
  • A changing total is not useful if blocked identities disappear.

Check your work

  • Reconcile counts without premature green status.
  • Name receiving authority and evidence.
  • Close the board-to-work-to-board loop.

Run a practice session

Materials

  • Order tokens and response board
  • Blank plan/actual/action record
  • Partial-recovery card
  1. Define ready · 4 minutes

    What does the actual count include?

  2. Run a short huddle · 7 minutes

    Who accepted the label issue?

  3. Practice partial recovery · 8 minutes

    Which identities remain open?

  4. Debrief closure · 5 minutes

    What must come back from support?

Debrief

  • Ask learners to point to the evidence behind a green status.
  • Keep the huddle focused on response and review rather than debating every cause.

Use tokens to update each verified case, then reconcile the board total.

Transfer into the work

Owner: Frontline lead with receiving support owners

Record: Plan/actual gap board and linked action records

Review: At agreed intraday checks and next daily huddle

Evidence: Observed condition change, accepted escalation and correct remaining scope

Escalate missing authority/response and assign deeper investigation for recurring gaps.
